MAY 2014

MAY 2014

MAY 2014

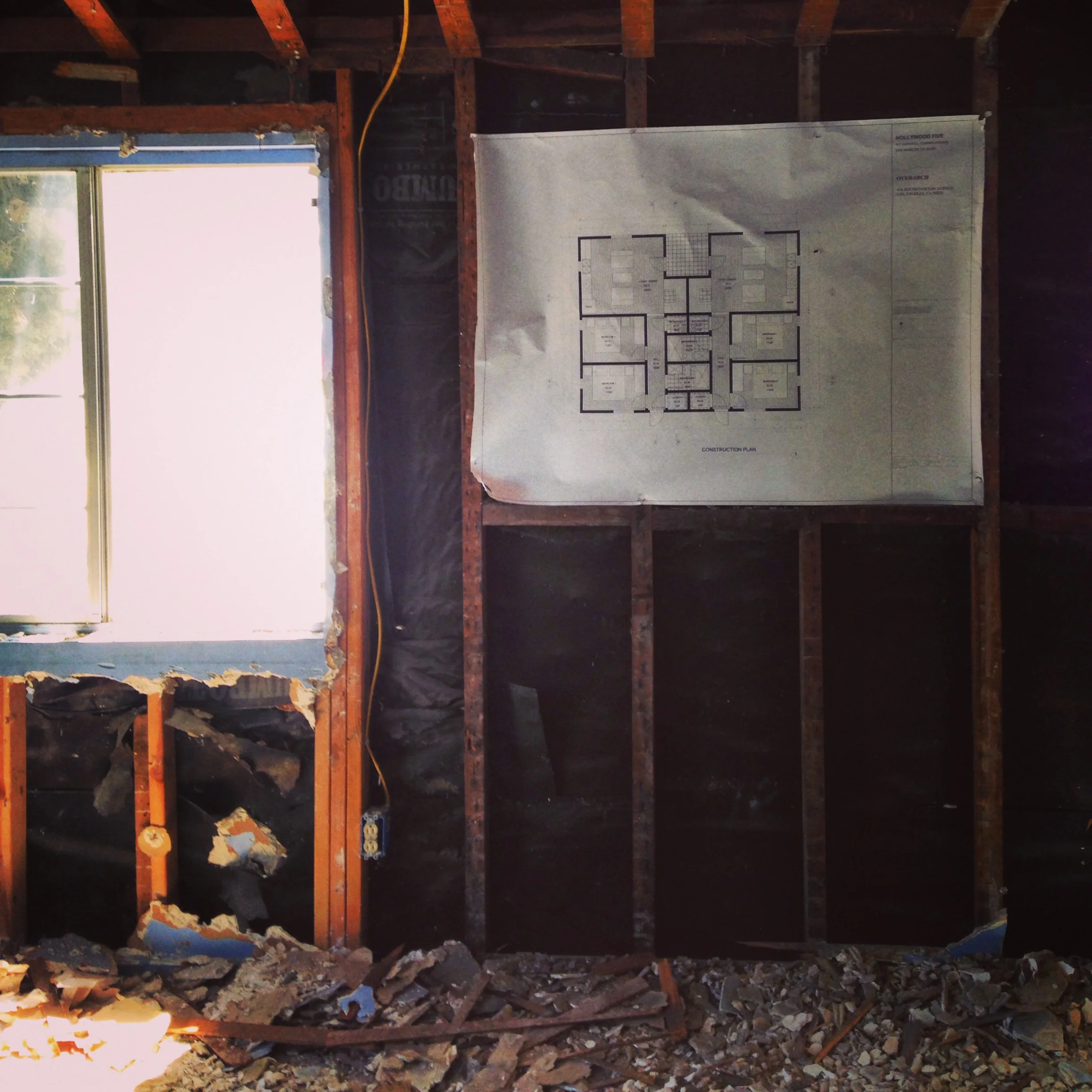

Initial demolition at 6000-6002 Barton Avenue. Owner builder!

OCTOBER 2014

OCTOBER 2014

OCTOBER 2014

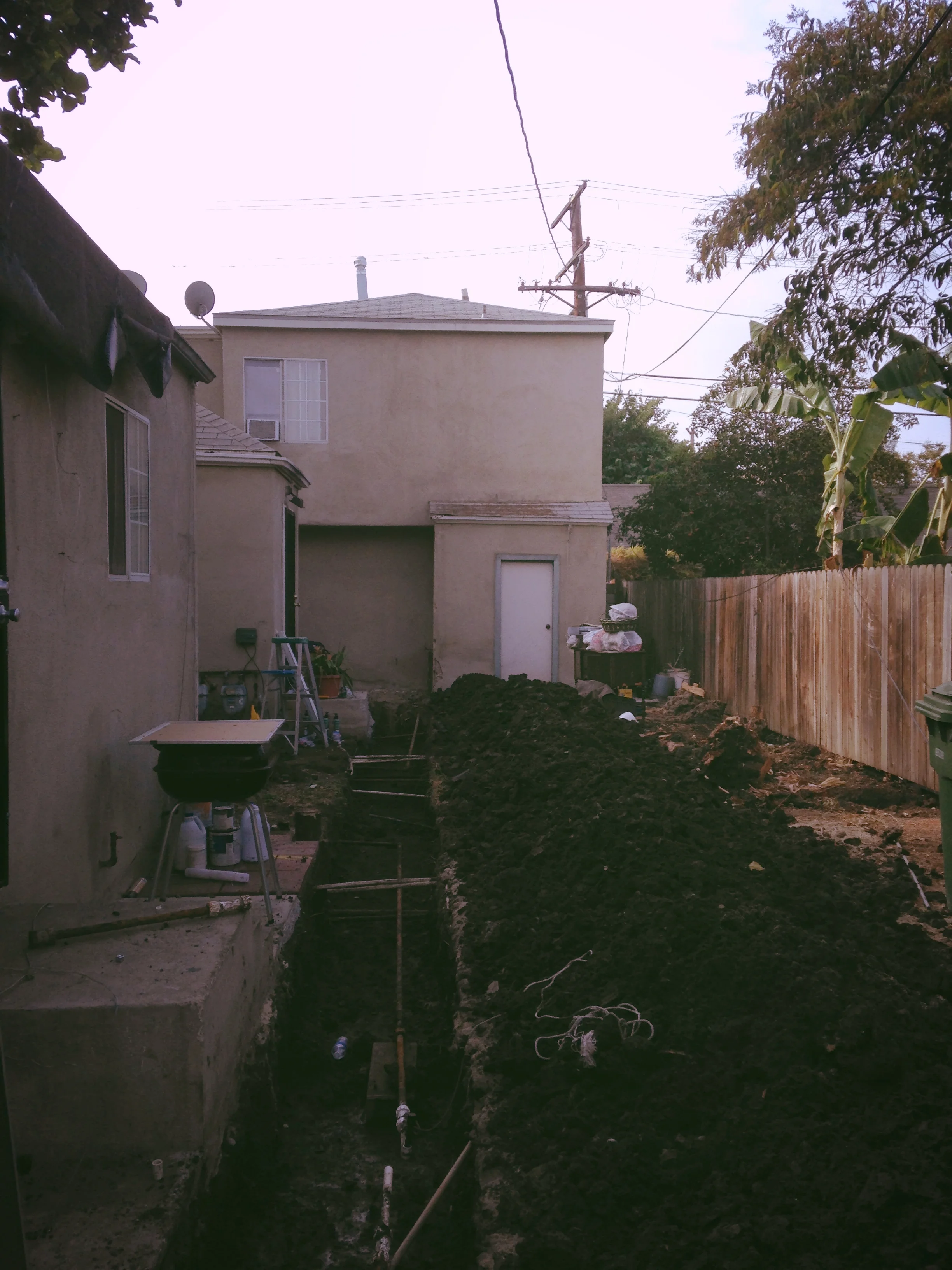

Site improvements underway. Trenching for new underground power and water service upgrade to 1-1/2" pipe.

OCTOBER 2014

OCTOBER 2014

OCTOBER 2014

Existing conditions after site clearance. Original position of master electrical panel shown at rear of 6002 Barton Avenue. Permitted set used as vent block.

NOVEMBER 2014

NOVEMBER 2014

NOVEMBER 2014

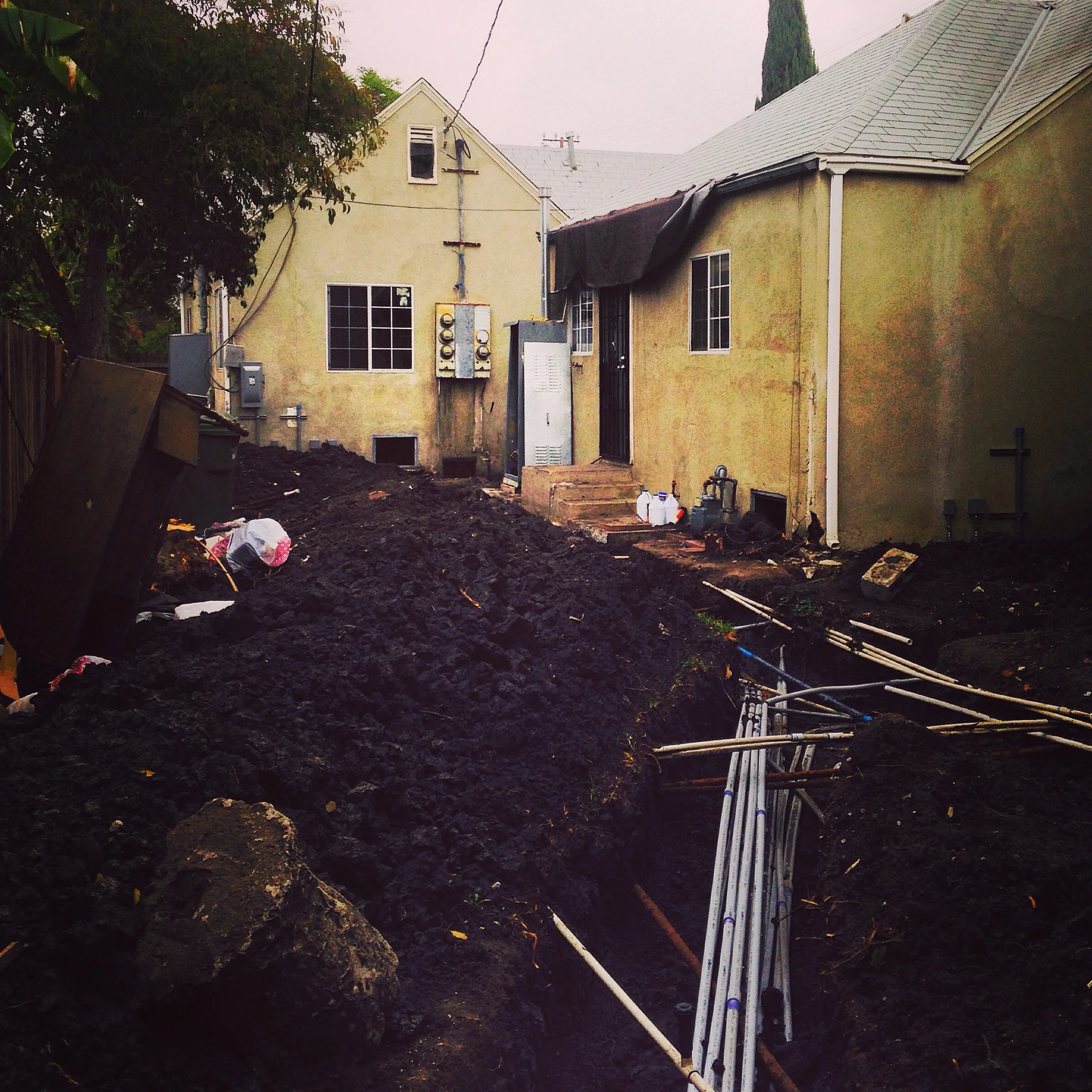

New electrical conduits run between upgraded panel location at garage and remote units.

DECEMBER 2014

DECEMBER 2014

DECEMBER 2014

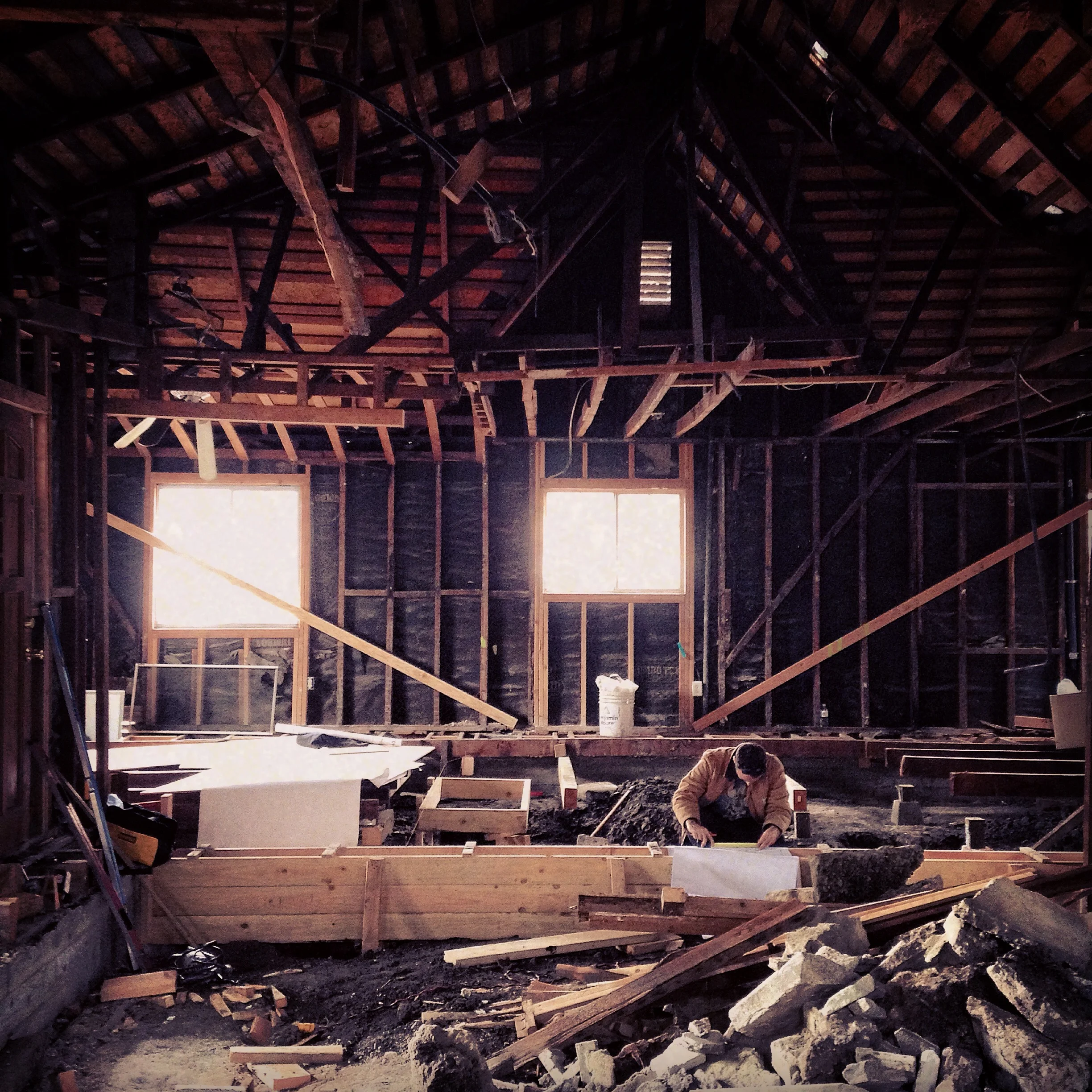

Supplemental foundation forms in place and interior demolition scope complete at 6000-6002 Barton Avenue.

DECEMBER 2014

DECEMBER 2014

DECEMBER 2014

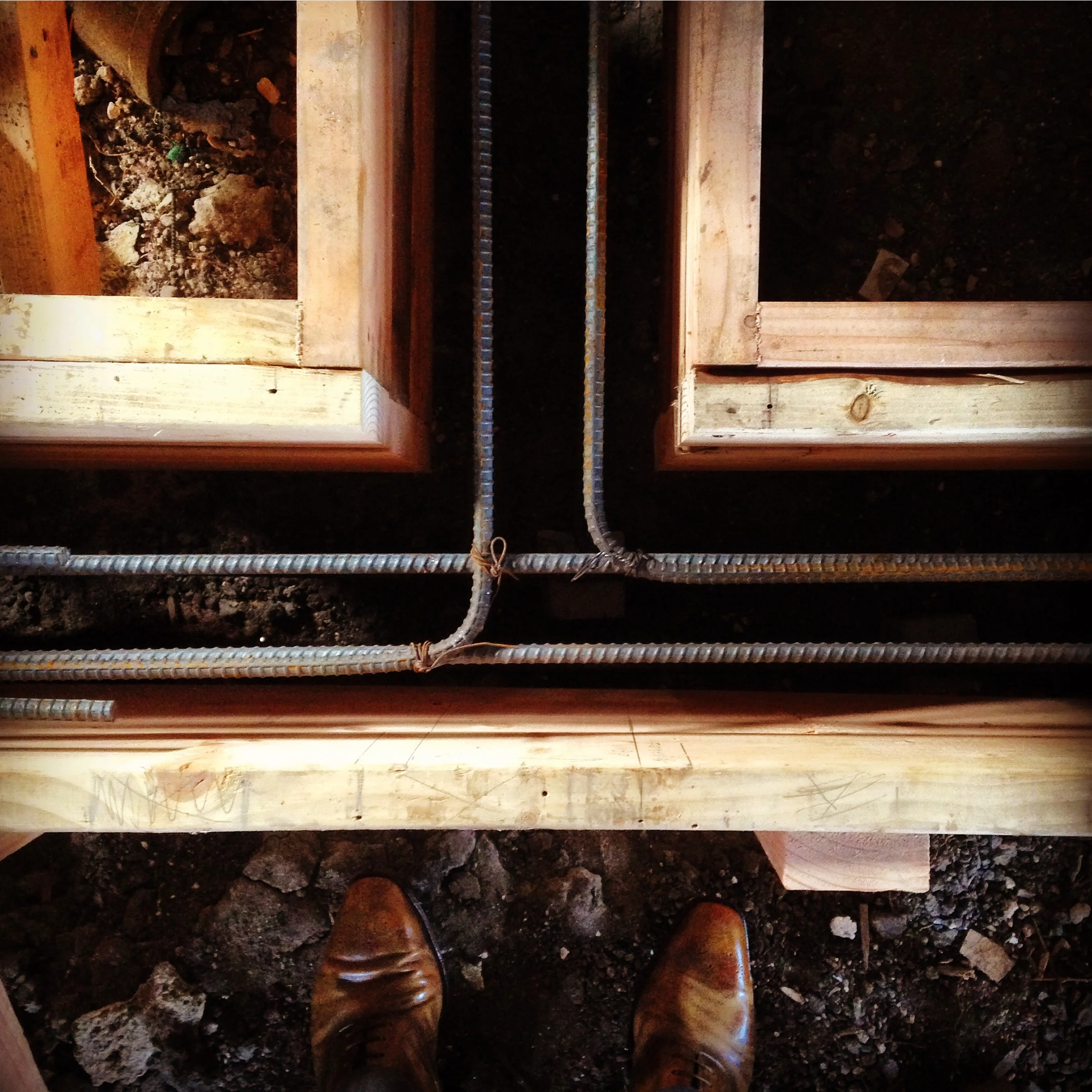

Formwork for supplemental foundation. Hand tied rebar.

JANUARY 2015

JANUARY 2015

JANUARY 2015

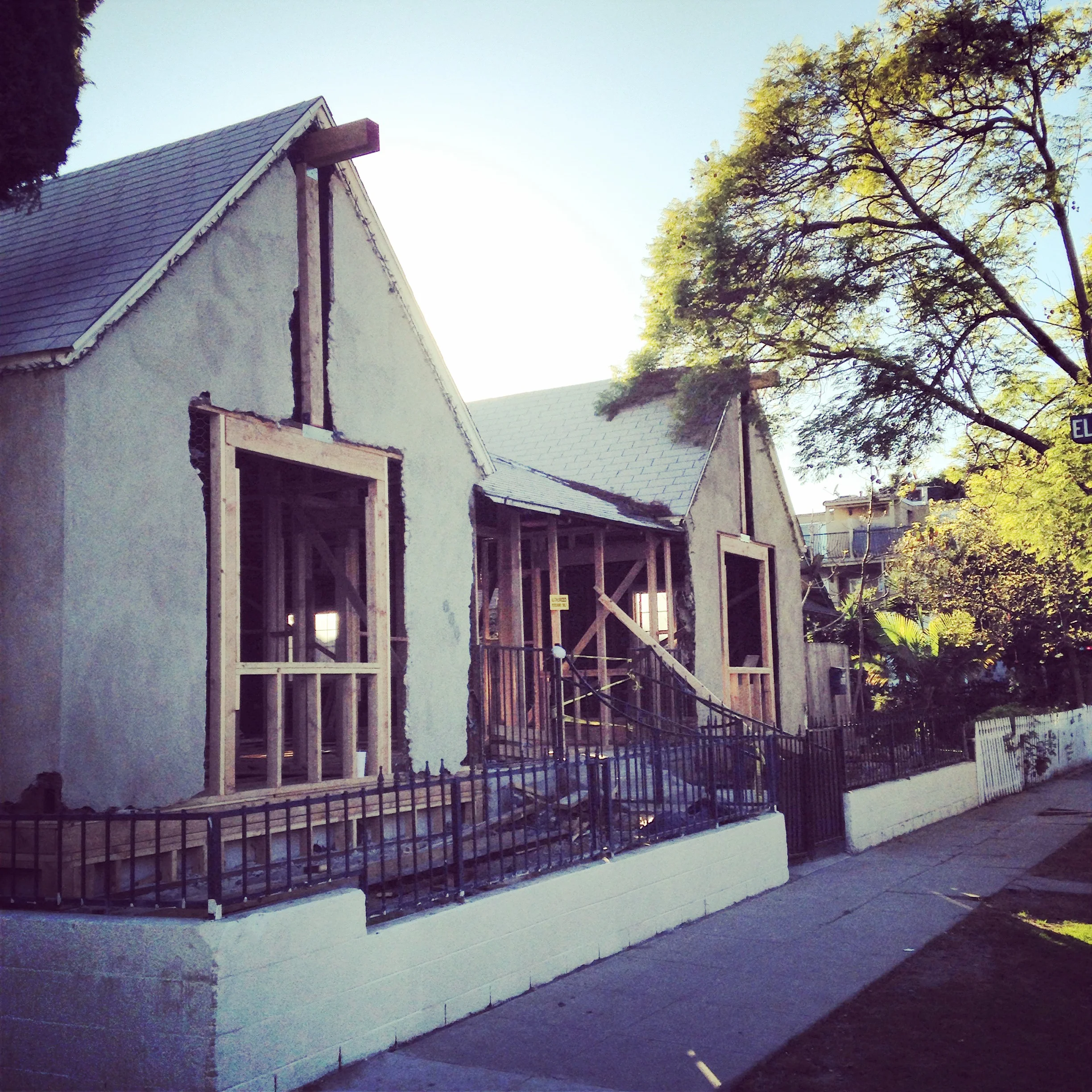

Existing conditions at Barton Avenue entry.

JANUARY 2015

JANUARY 2015

JANUARY 2015

View of intersection at El Centro and Barton Avenues. Window positions reflect un-permitted work during 2004 renovation.

JANUARY 2015

JANUARY 2015

JANUARY 2015

Structural reinforcement and new window framing at Barton Avenue.

JANUARY 2015

JANUARY 2015

JANUARY 2015

Ceiling joist removal and temporary shoring at future master bedroom location in 6002 Barton Avenue.

FEBRUARY 2015

FEBRUARY 2015

FEBRUARY 2015

No turf too small.

FEBRUARY 2015

FEBRUARY 2015

FEBRUARY 2015

Rough plumbing ready for inspection at 6000-6002 Barton Avenue.

MARCH 2015

MARCH 2015

MARCH 2015

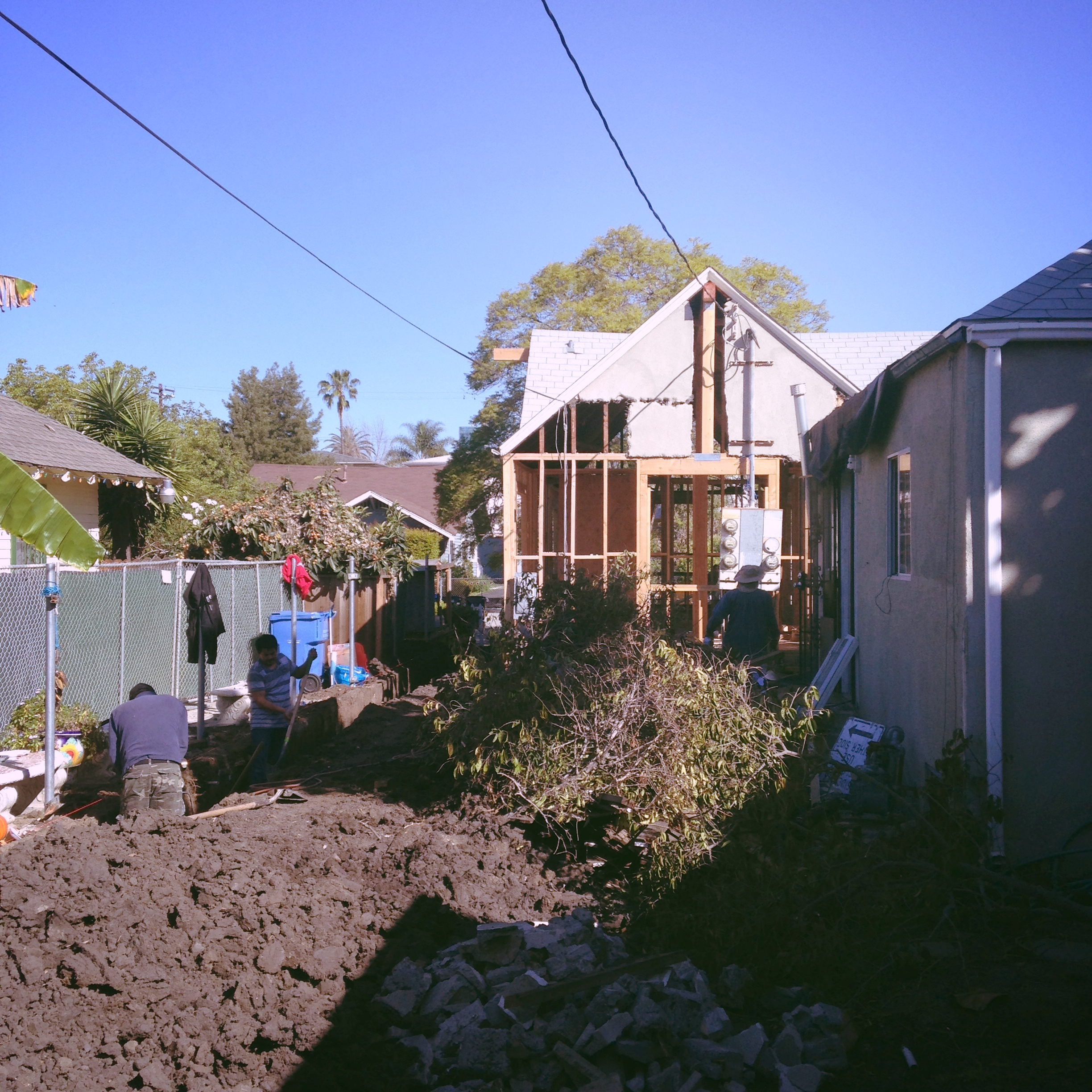

Trenching for new block wall at west property line.

MARCH 2015

MARCH 2015

MARCH 2015

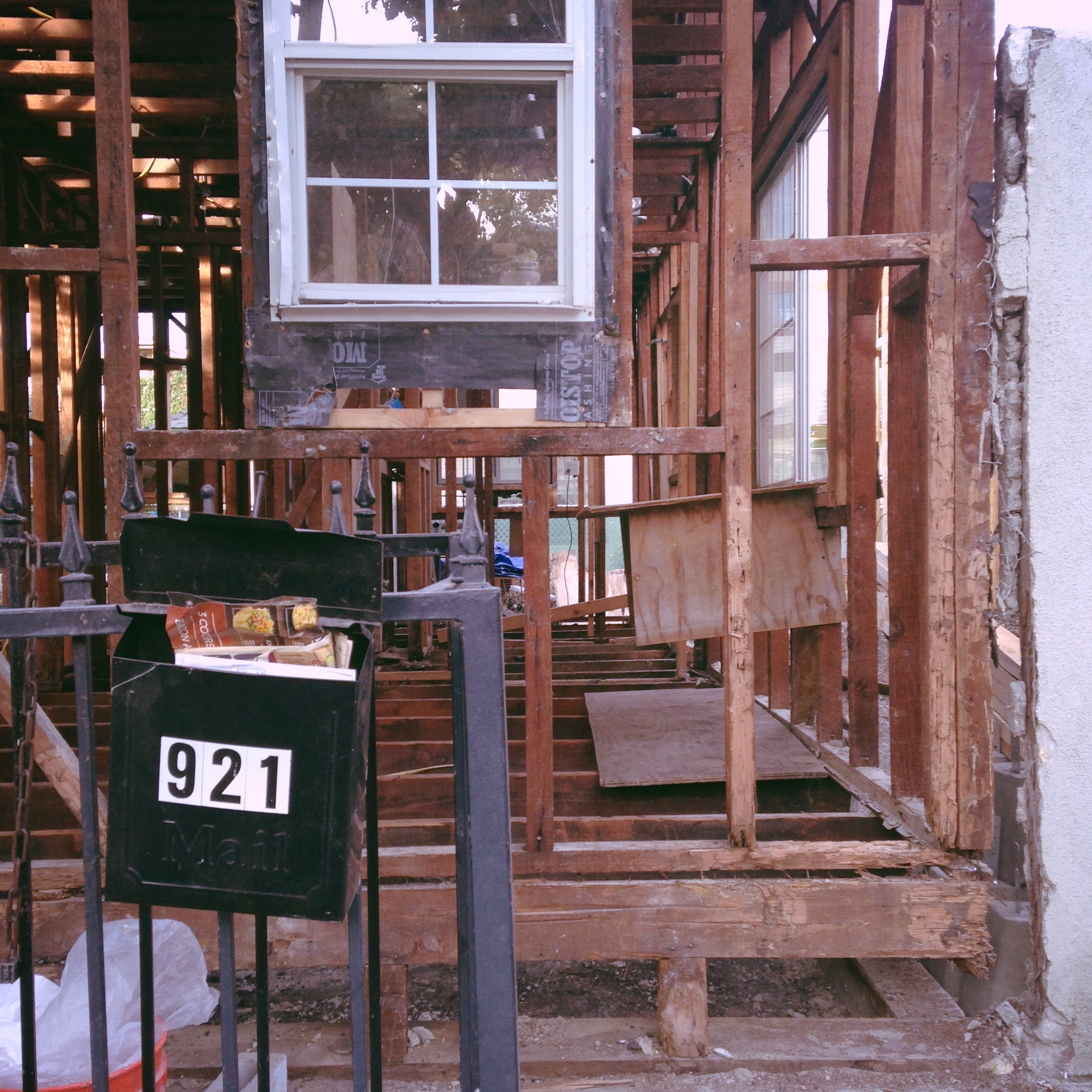

Demolition begins at 921 North El Centro Avenue. Second interior remodel permit.

MARCH 2015

MARCH 2015

MARCH 2015

You've got mail!

APRIL 2015

APRIL 2015

APRIL 2015

Window installation at 6000 Barton Avenue.

APRIL 2015

APRIL 2015

APRIL 2015

Skylights and structural reinforcement at Barton Avenue.

JULY 2015

JULY 2015

JULY 2015

View from 917 North El Centro Avenue of sheathing and window installation at 921 North El Centro.

JULY 2015

JULY 2015

JULY 2015

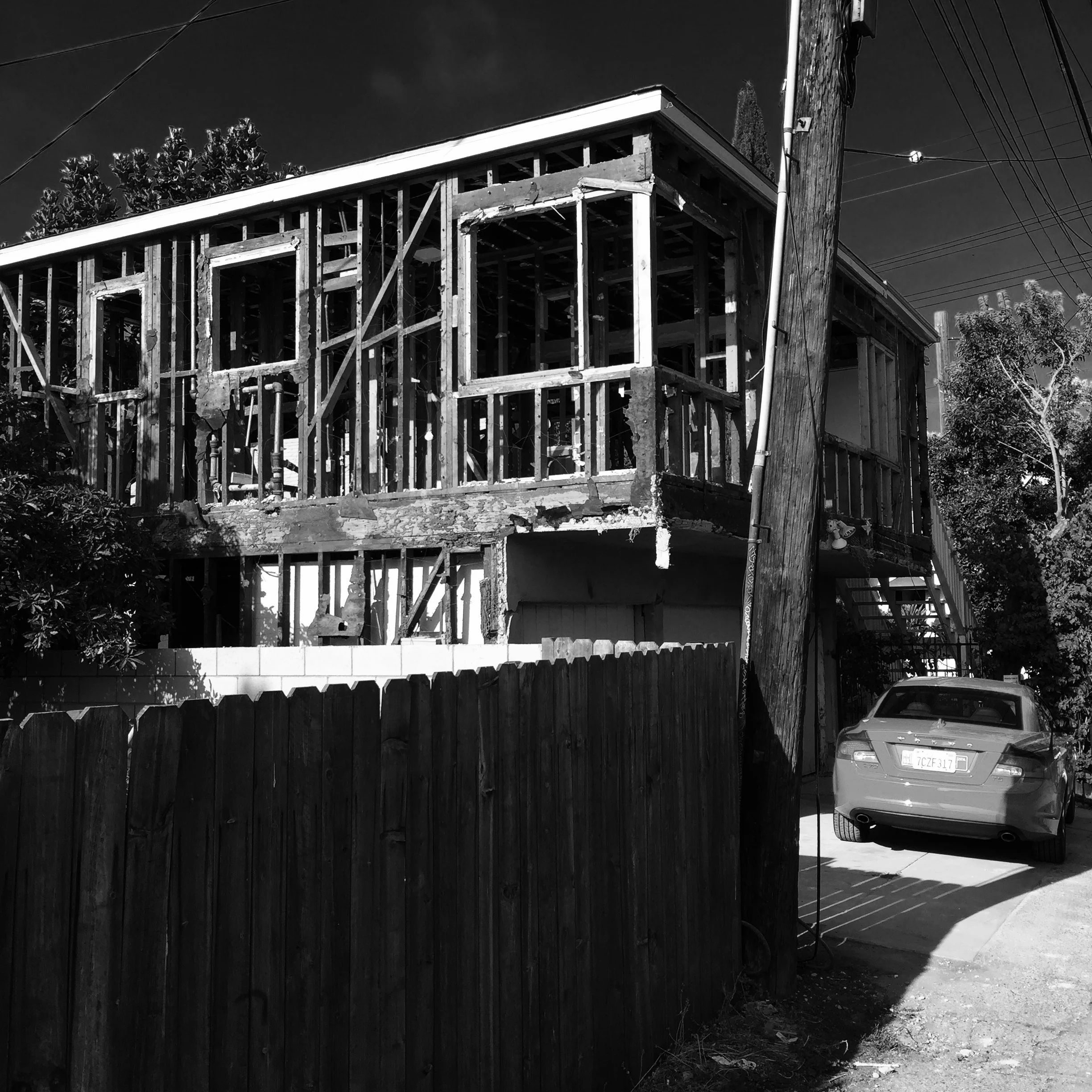

Demolition at 917 North El Centro Avenue. Third interior remodel permit.

JULY 2015

JULY 2015

JULY 2015

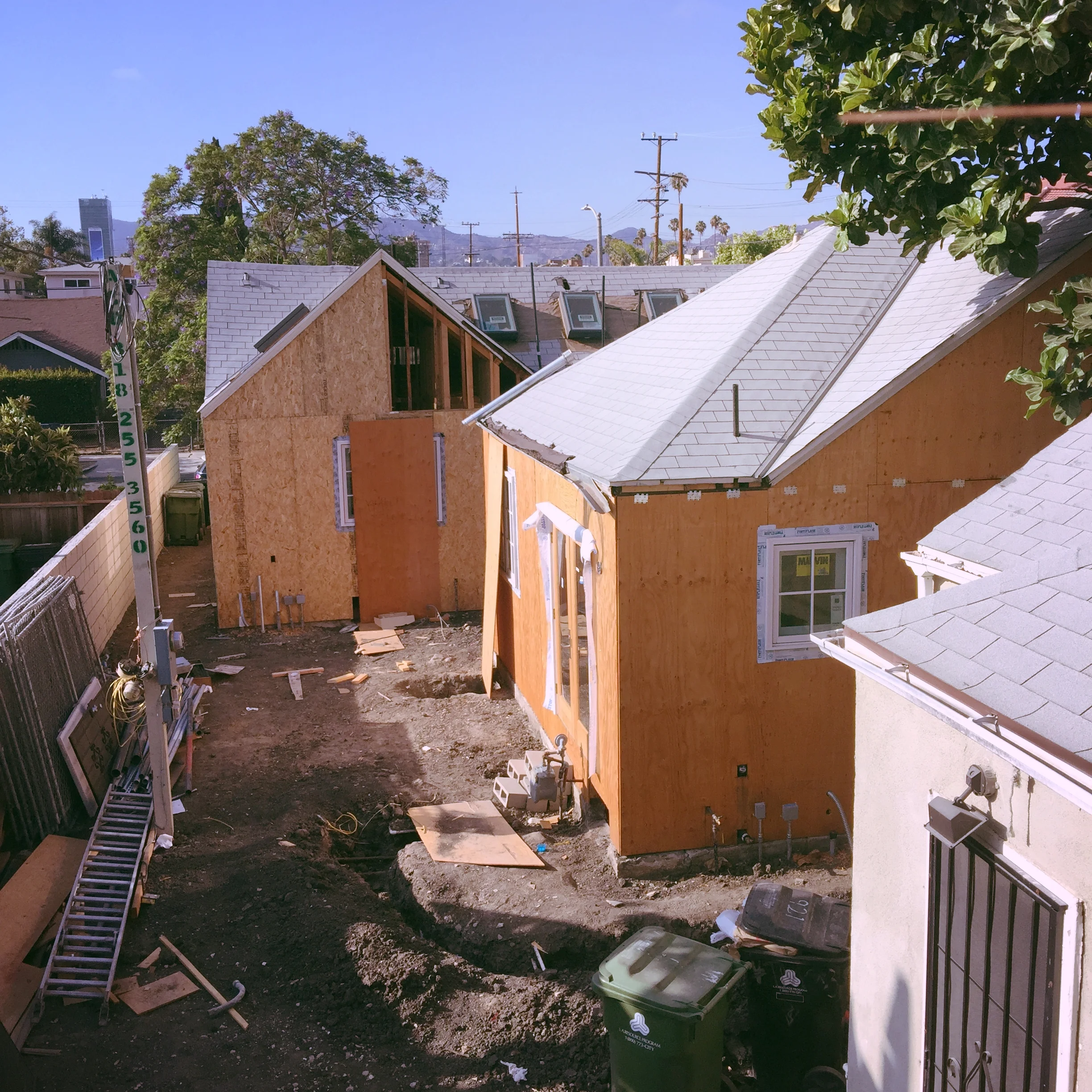

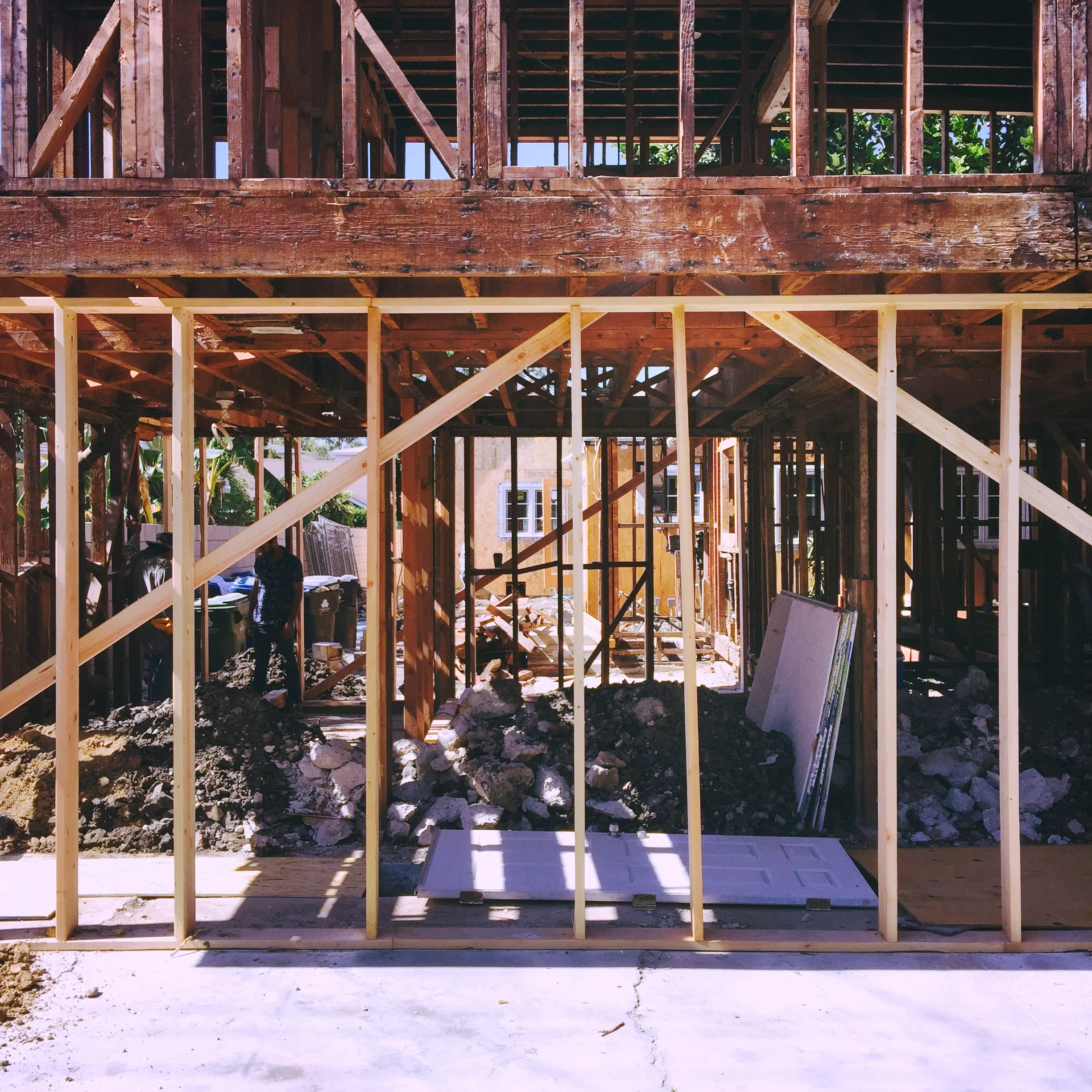

Demolition underway at 917-919 North El Centro Avenue.

JULY 2015

JULY 2015

JULY 2015

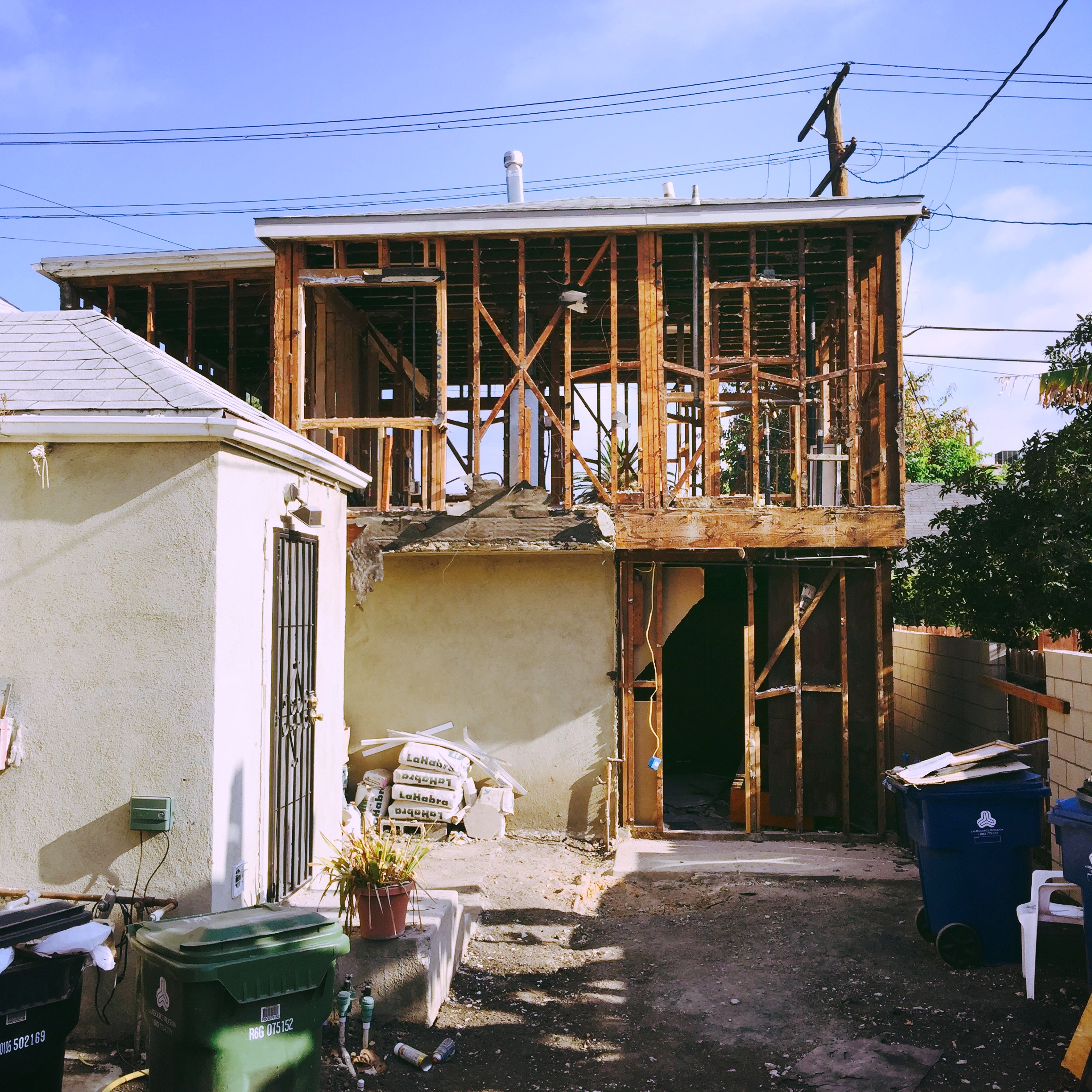

Demolition complete at 919 North El Centro Avenue.

JULY 2015

JULY 2015

JULY 2015

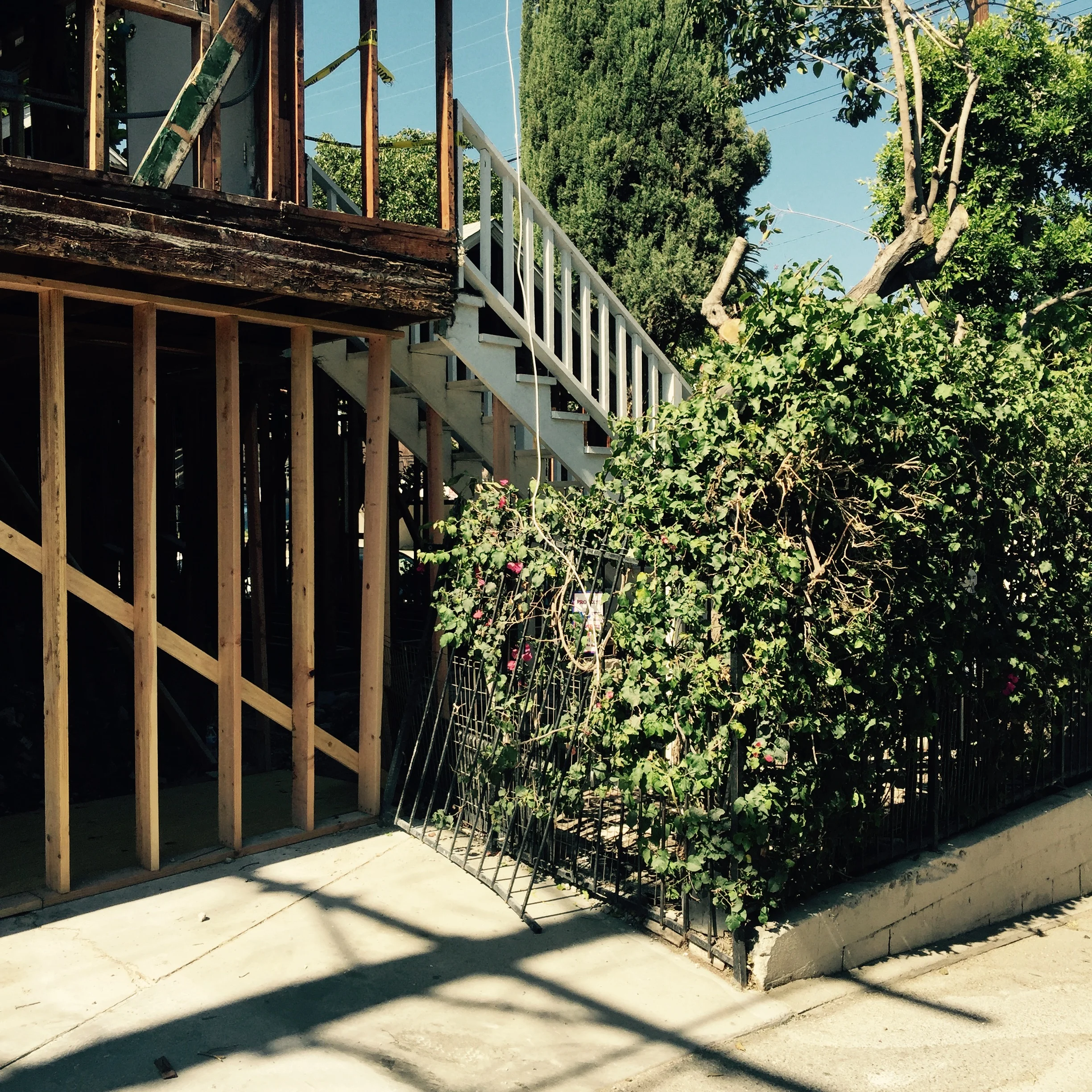

View of garage at alley showing temporary shoring and existing vegetation at future rear entry gate.

JULY 2015

JULY 2015

JULY 2015

Temporary shoring and slab demolition at garage.

AUGUST 2015

AUGUST 2015

AUGUST 2015

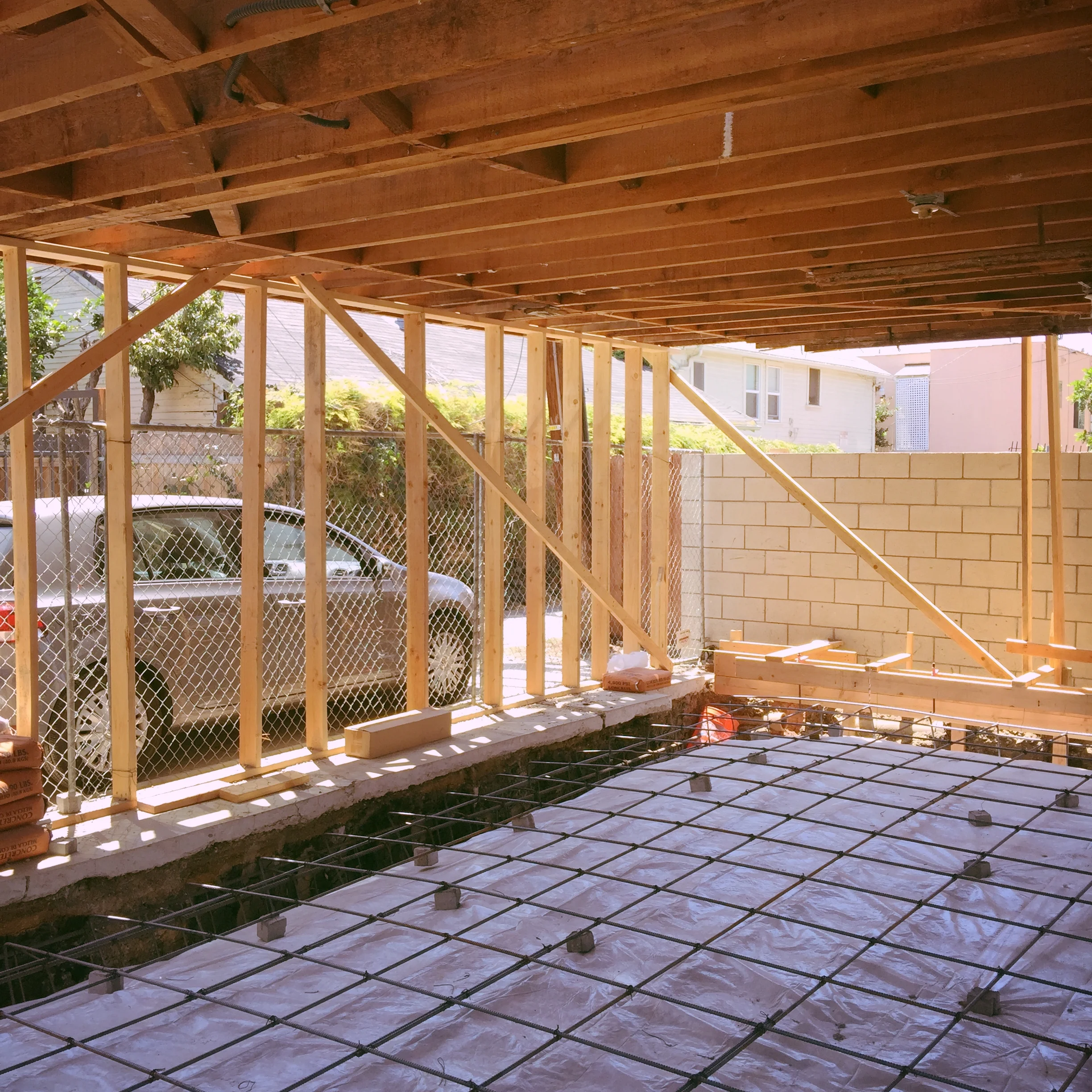

Site clearance and preparation for new slab pour at garage.

AUGUST 2015

AUGUST 2015

AUGUST 2015

Rebar at garage slab.

AUGUST 2015

AUGUST 2015

AUGUST 2015

Pour day.

AUGUST 2015

AUGUST 2015

AUGUST 2015

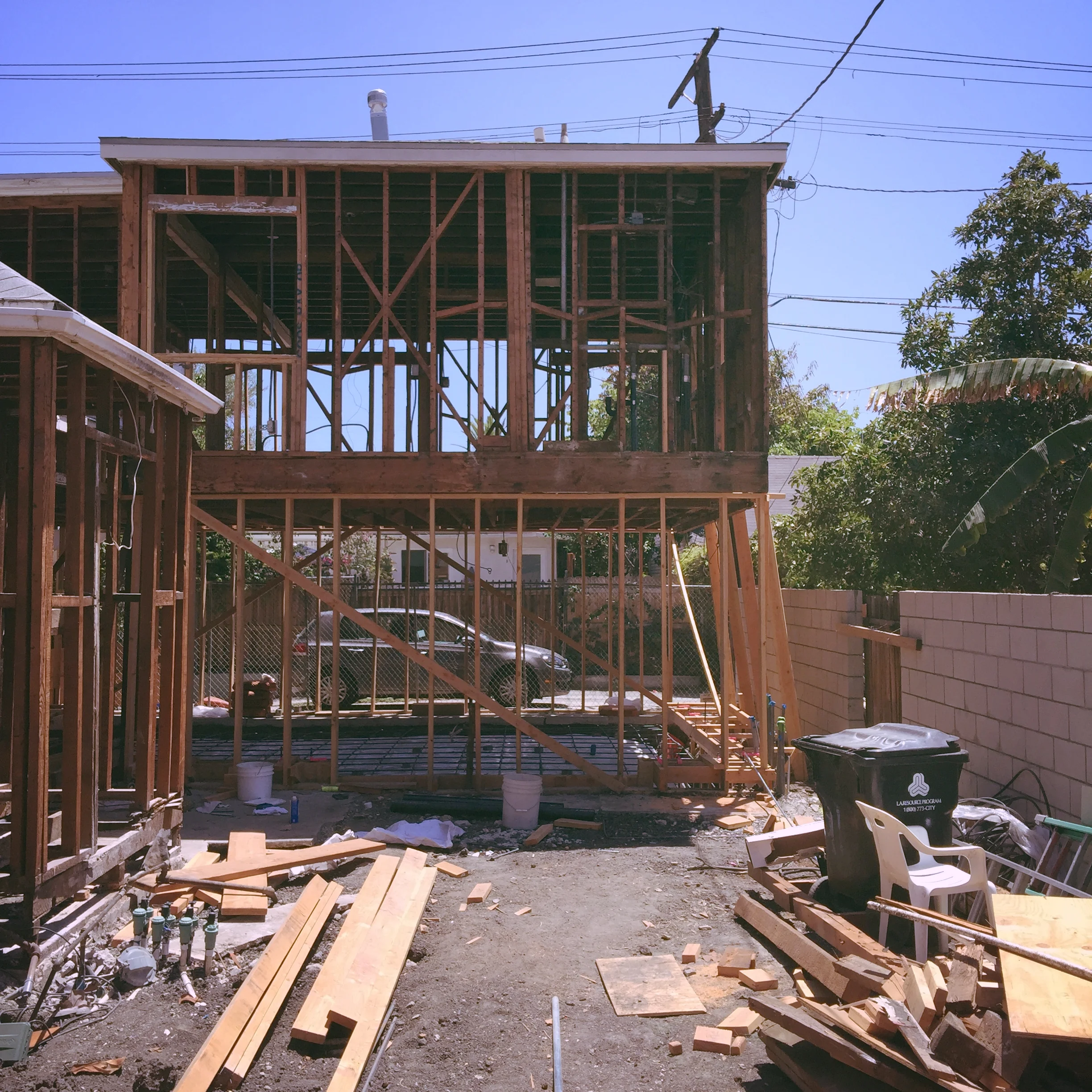

Slab complete and moment frame installed as seismic retrofit for 917-919 North El Centro Avenue. Future evidence for LADBS!

AUGUST 2015

AUGUST 2015

AUGUST 2015

HVAC installation underway at 6002 Barton Avenue.

AUGUST 2015

AUGUST 2015

AUGUST 2015

Sheathing complete at Barton Avenue.

AUGUST 2015

AUGUST 2015

AUGUST 2015

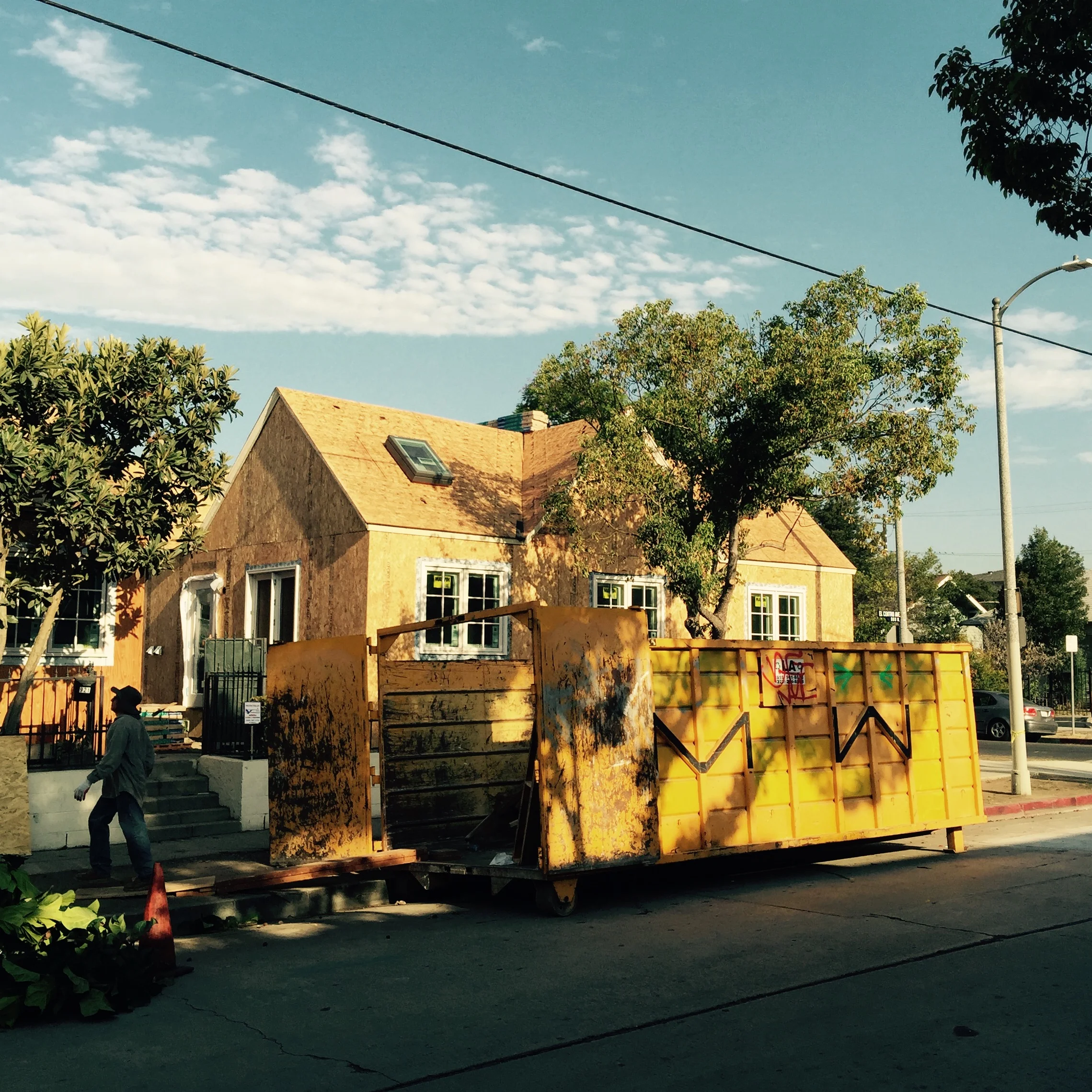

Dumpster ready for removal of giant fig tree at 921 North El Centro.

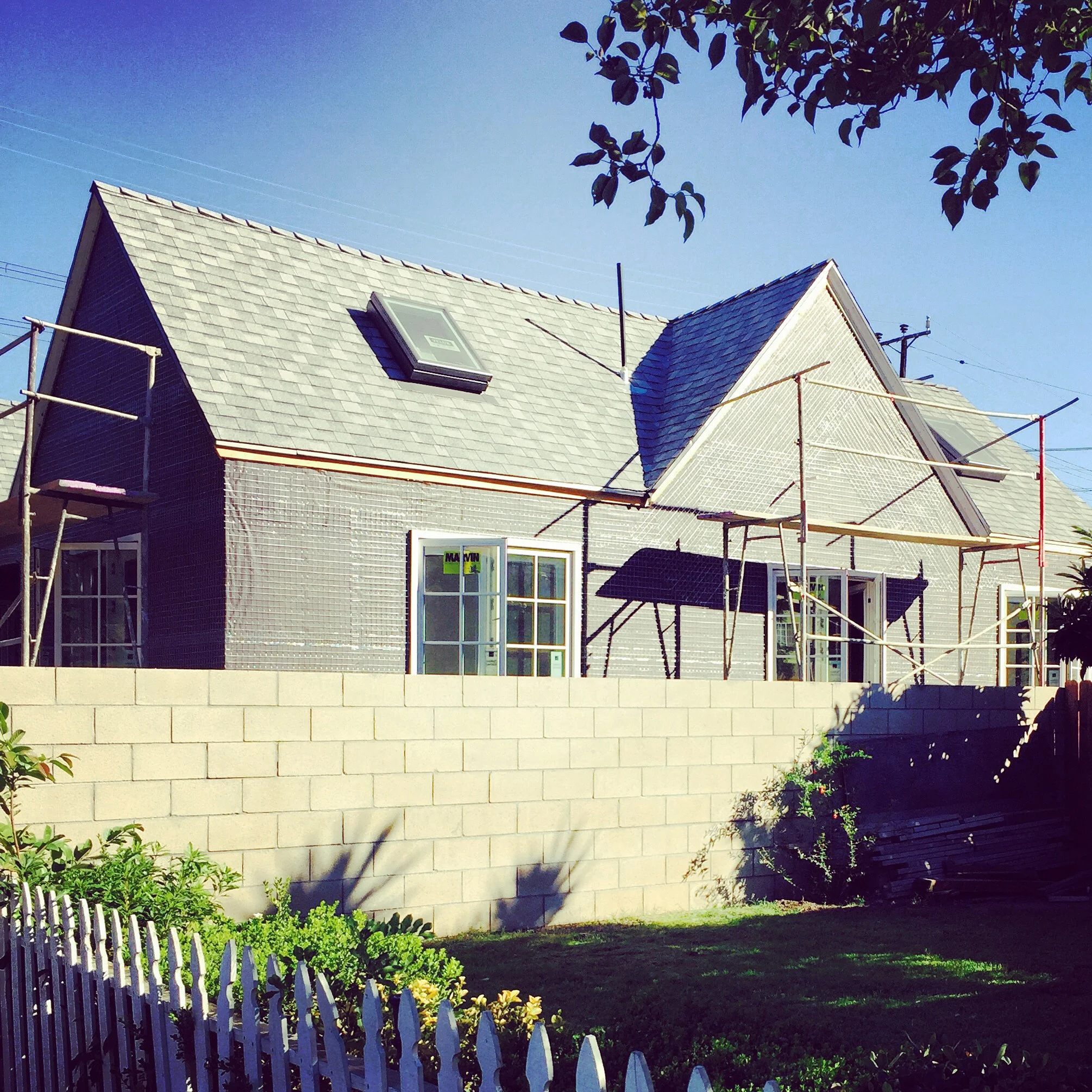

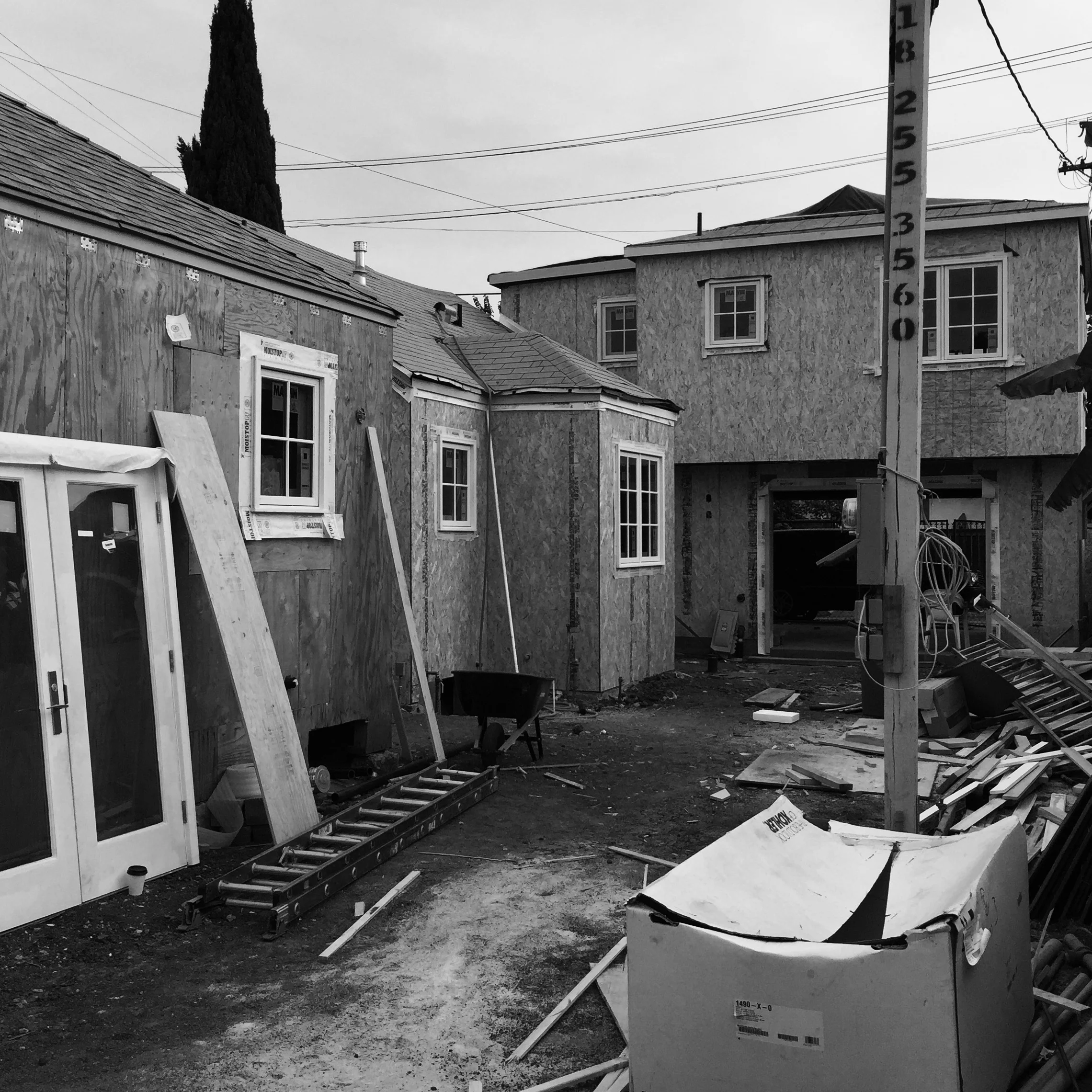

OCTOBER 2015

OCTOBER 2015

OCTOBER 2015

All windows and most doors installed on property. Bath fixtures ready for install.

OCTOBER 2015

OCTOBER 2015

OCTOBER 2015

Waterproofing and lath ahead of stucco.

OCTOBER 2015

OCTOBER 2015

OCTOBER 2015

Underlayment complete at Barton Avenue.

OCTOBER 2015

OCTOBER 2015

OCTOBER 2015

El Centro facade showing reverse color palette. Dark walls, white trim.

NOVEMBER 2015

NOVEMBER 2015

NOVEMBER 2015

View of intersection at Barton and El Centro Avenues day before stucco scratch coat.

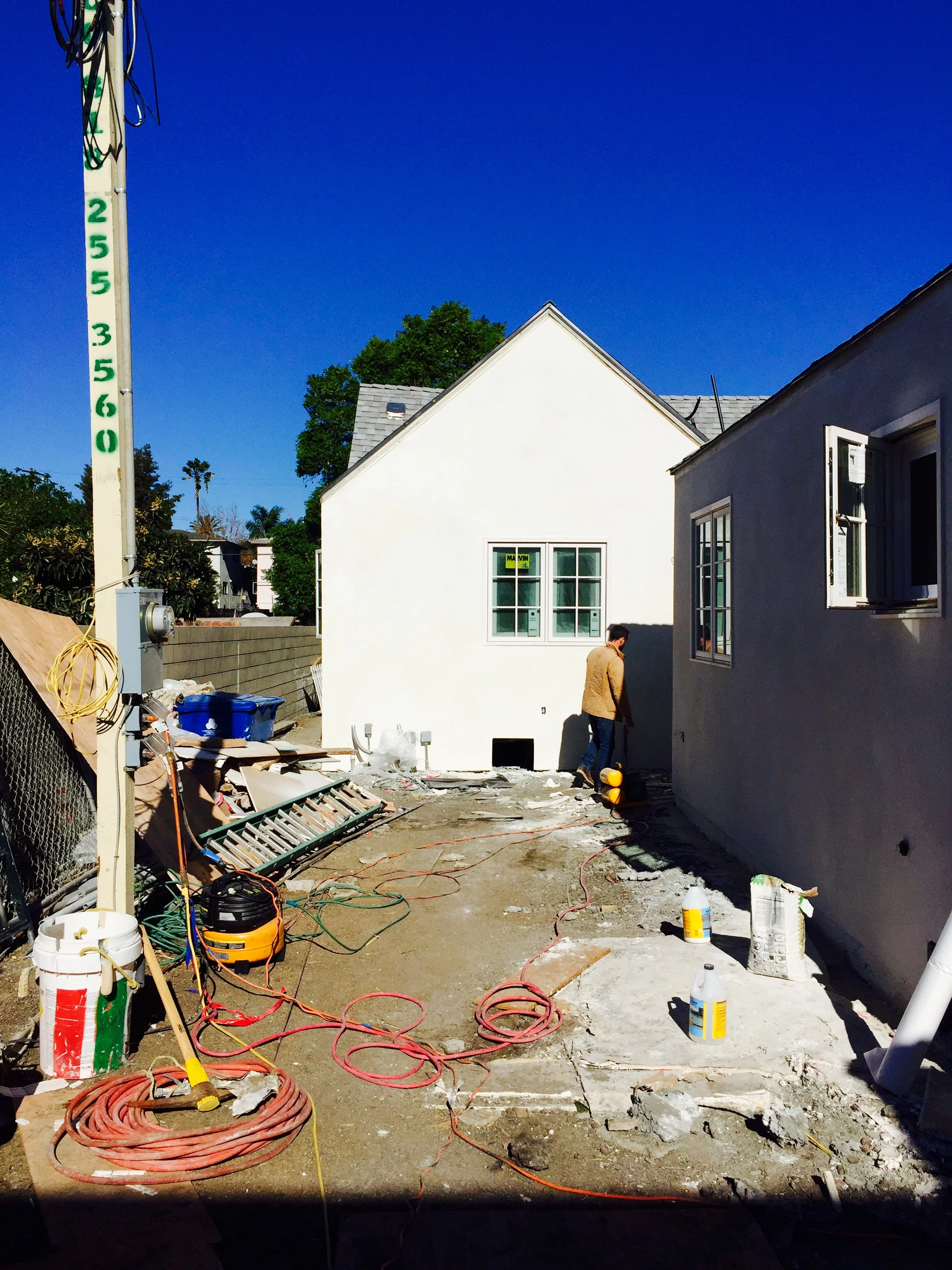

DECEMBER 2015

DECEMBER 2015

DECEMBER 2015

Grey, grey, grey.

DECEMBER 2015

DECEMBER 2015

DECEMBER 2015

Ready for start of site and landscape contract.

JANUARY 2016

JANUARY 2016

JANUARY 2016

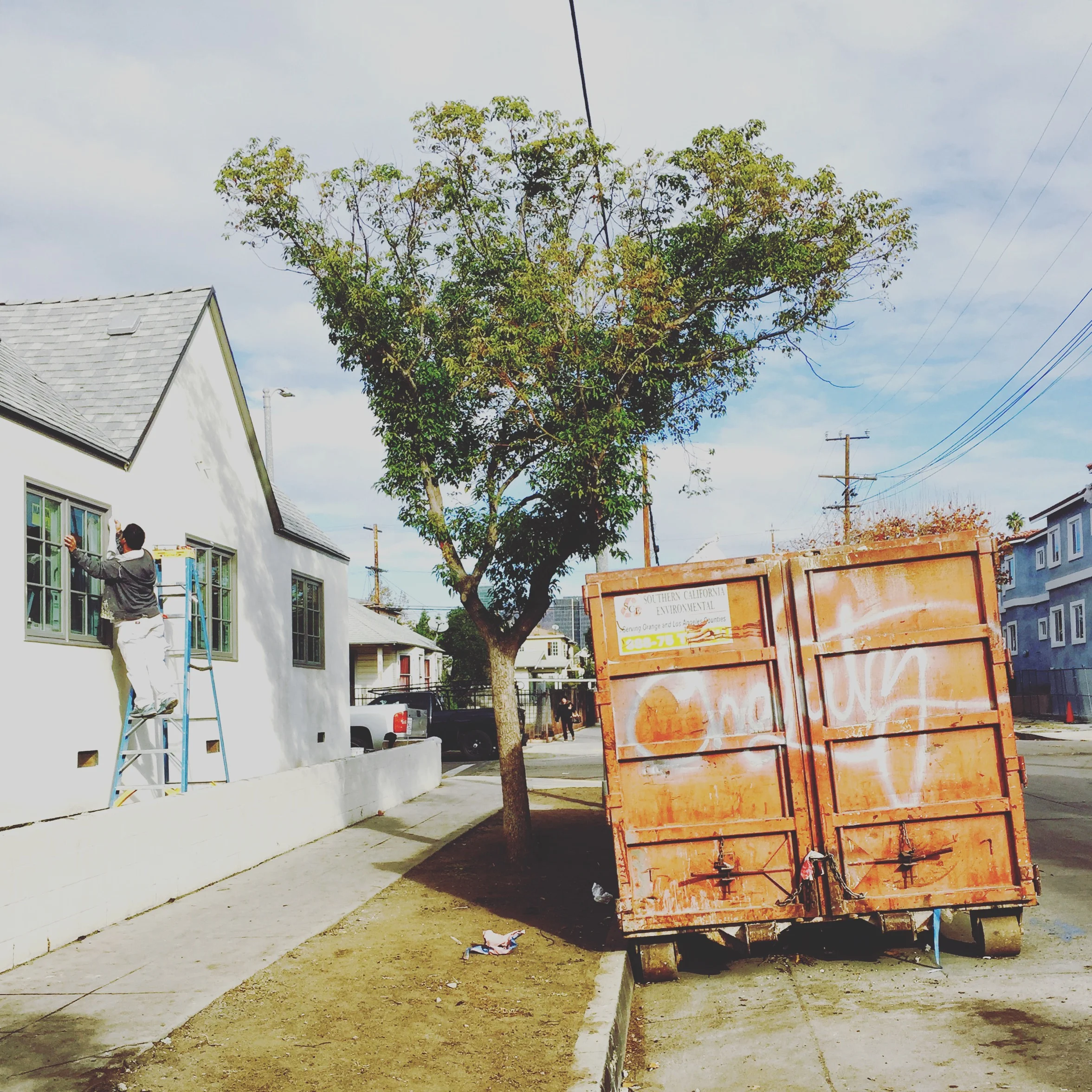

Trim painting.

JANUARY 2016

JANUARY 2016

JANUARY 2016

Stair at 917 North El Centro Avenue ready for rebuild.

JANUARY 2016

JANUARY 2016

JANUARY 2016

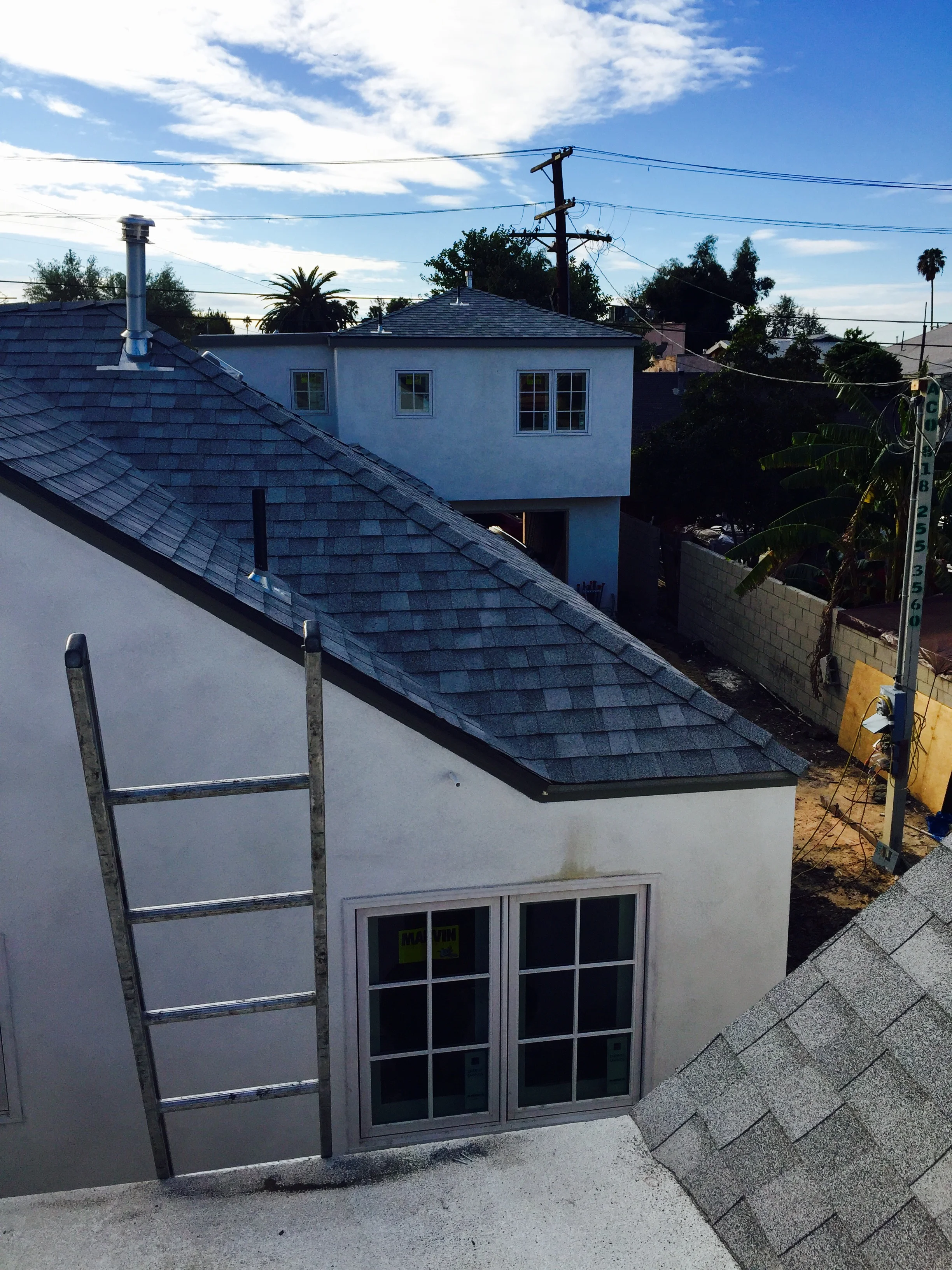

View of updated roof.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

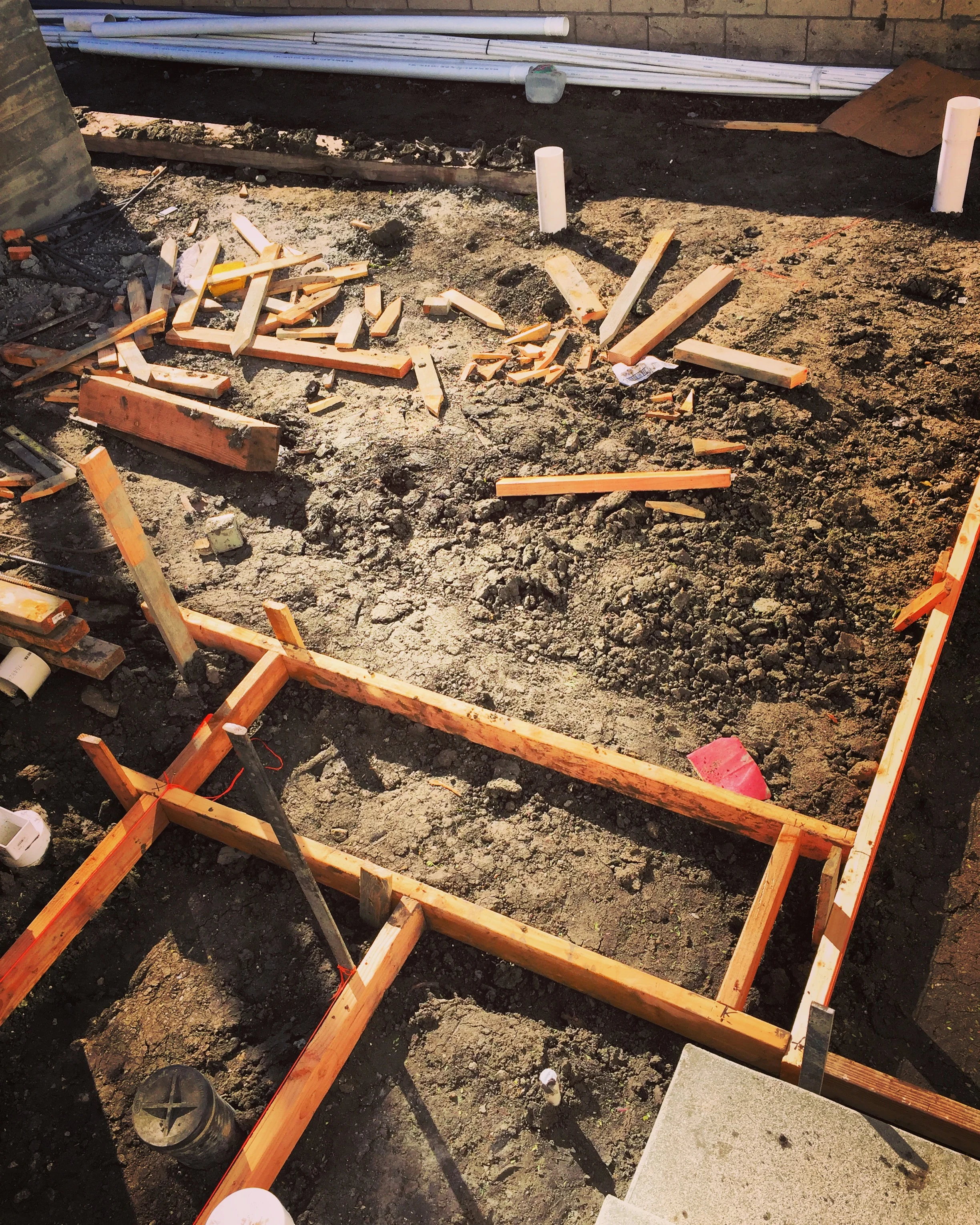

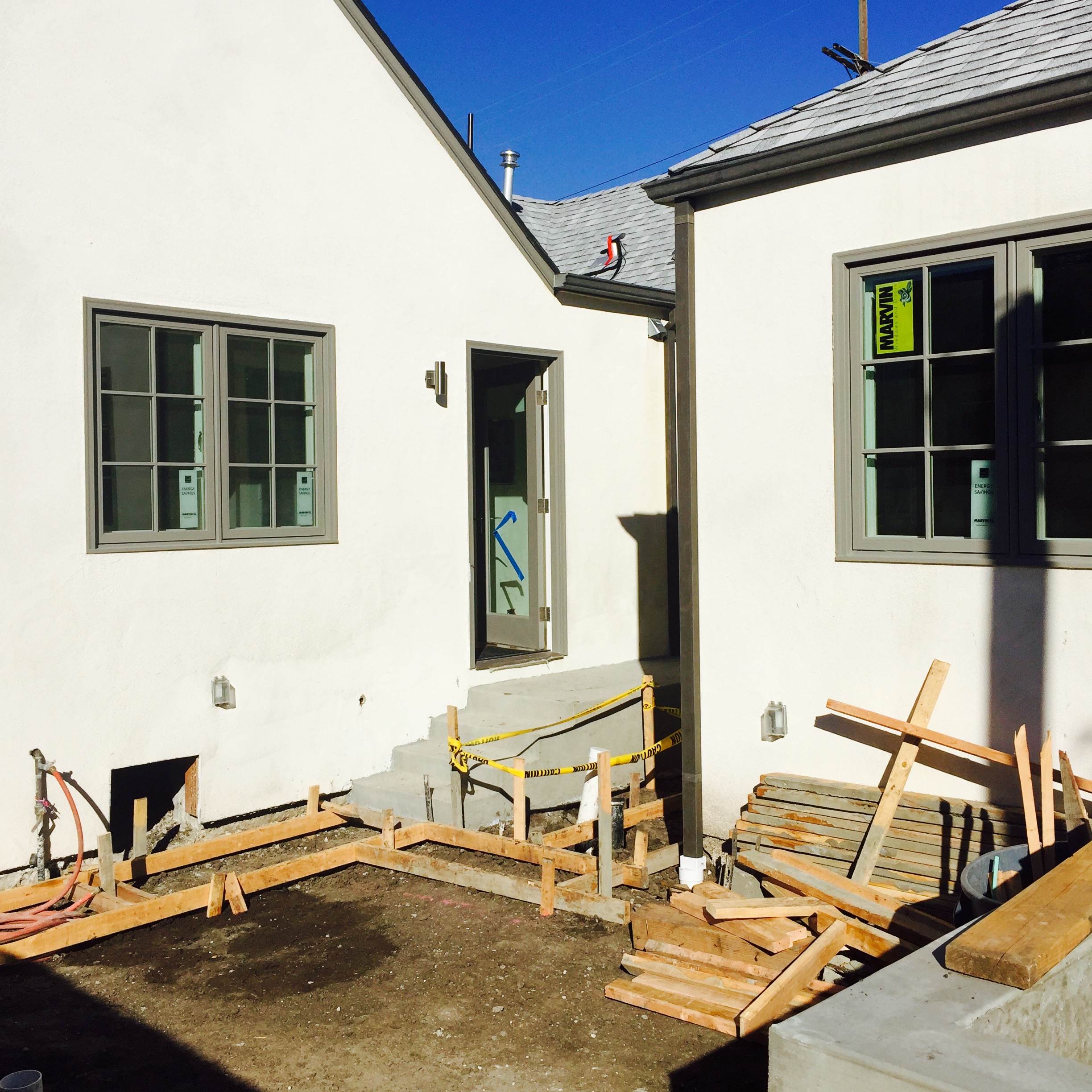

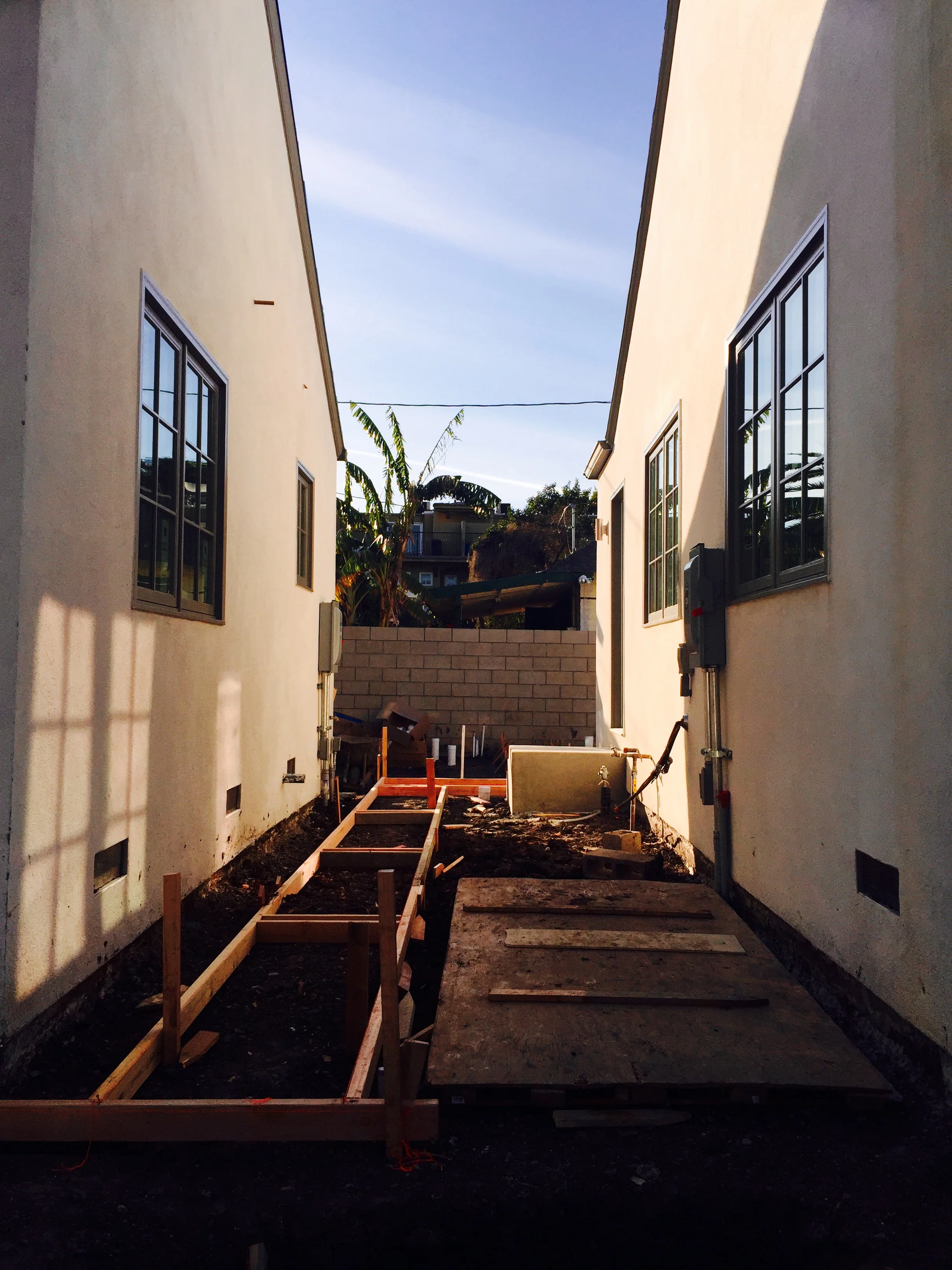

Flatwork forms underway.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

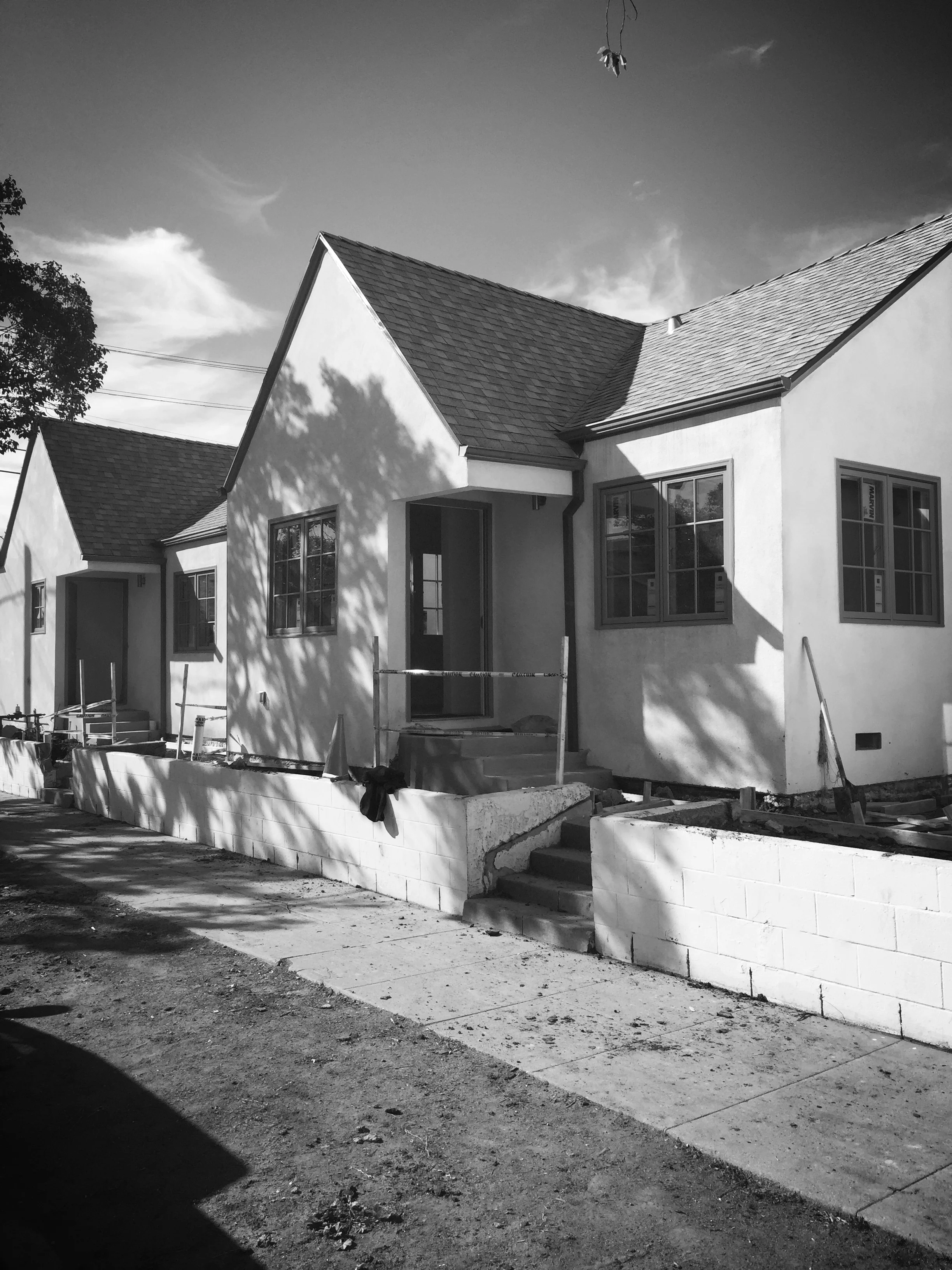

Some minor adjustments to the design.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

Future pocket garden between 919 and 921 North El Centro Avenue.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

Walkway pour.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

Ready for landscape install.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

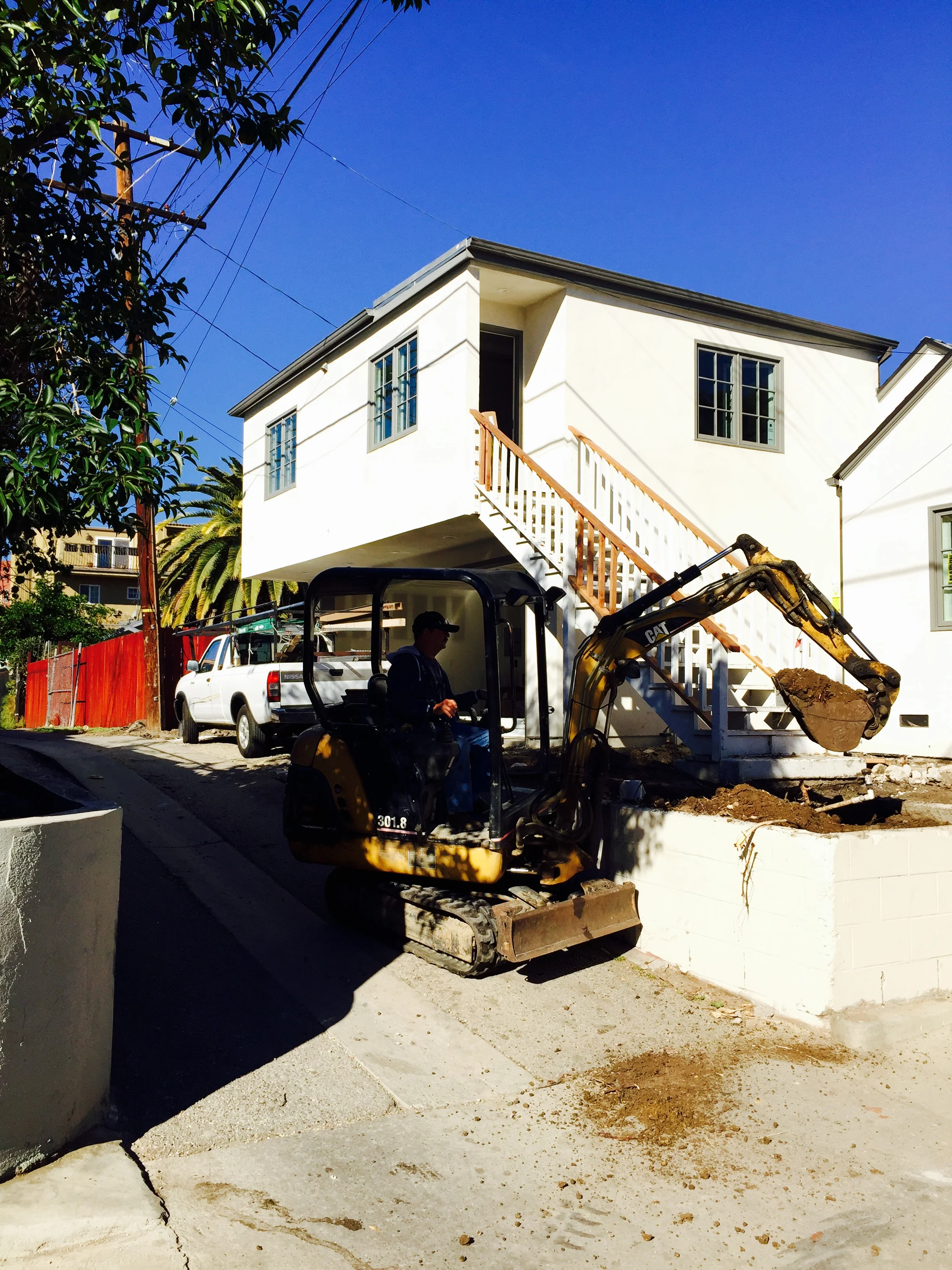

Jose getting busy with the mini backhoe.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

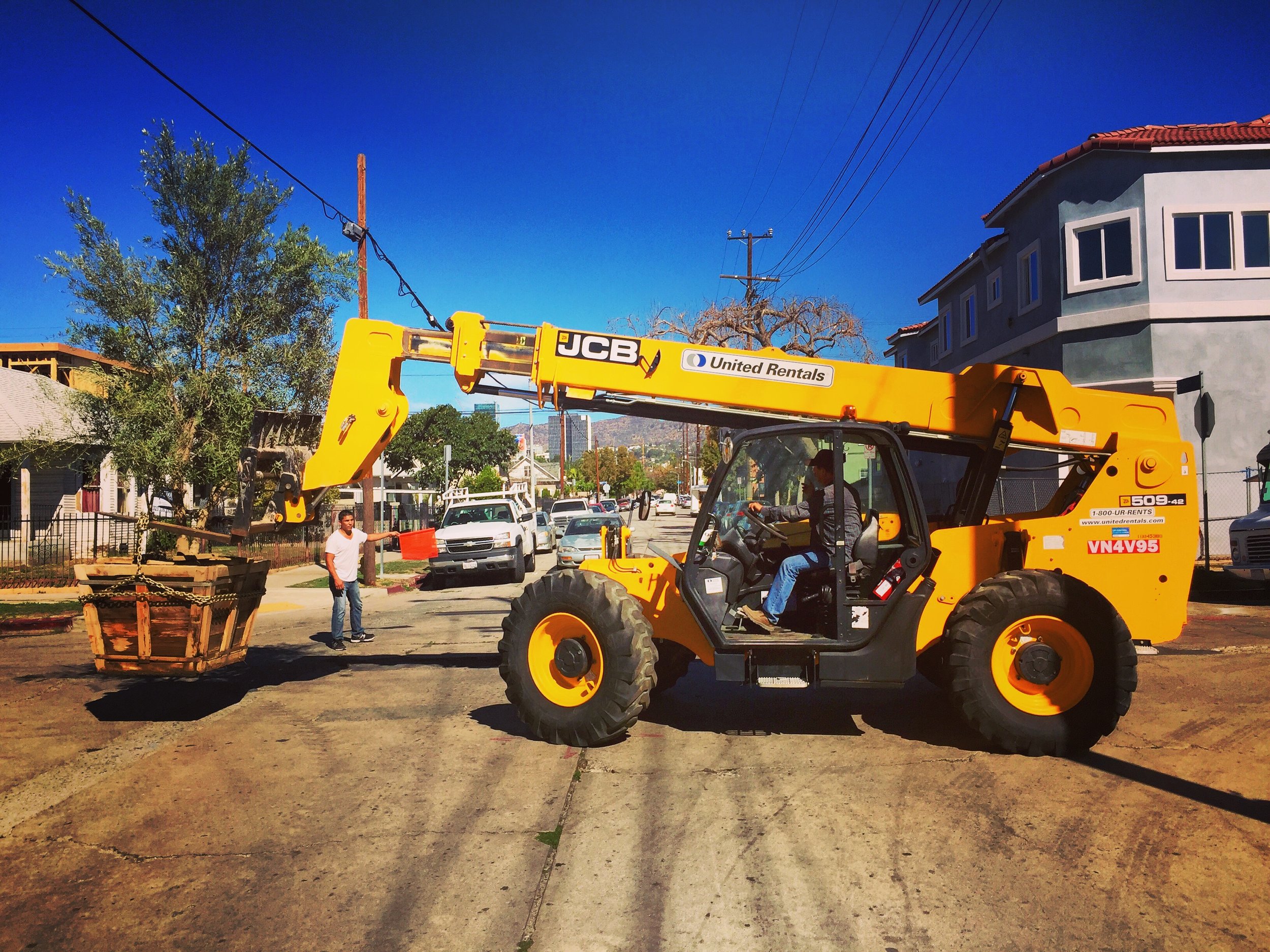

48" box olive trees being lifted into position. Unofficial road closure.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

More fun with heavy machinery.

FEBRUARY 2016

FEBRUARY 2016

FEBRUARY 2016

El Centro facade showing new olive trees.

MARCH 2016

MARCH 2016

MARCH 2016

6000 Barton Avenue showing new Crape Myrtle trees and guava bushes. Temporary copper drain pipe in place for hot water heater inspection.

MARCH 2016

MARCH 2016

MARCH 2016

Cara Cara orange trees in bloom. Tile goes in at Barton Avenue entry.

MARCH 2016

MARCH 2016

MARCH 2016

First day electrified.

MARCH 2016

MARCH 2016

MARCH 2016

Fence complete and plantation shutters installed. Ready for move-in.

MARCH 2016

MARCH 2016

MARCH 2016

First night for site lights.

APRIL 2016

APRIL 2016

APRIL 2016

Turf stone permeable pavers in and outdoor furniture installed.

APRIL 2016

APRIL 2016

APRIL 2016

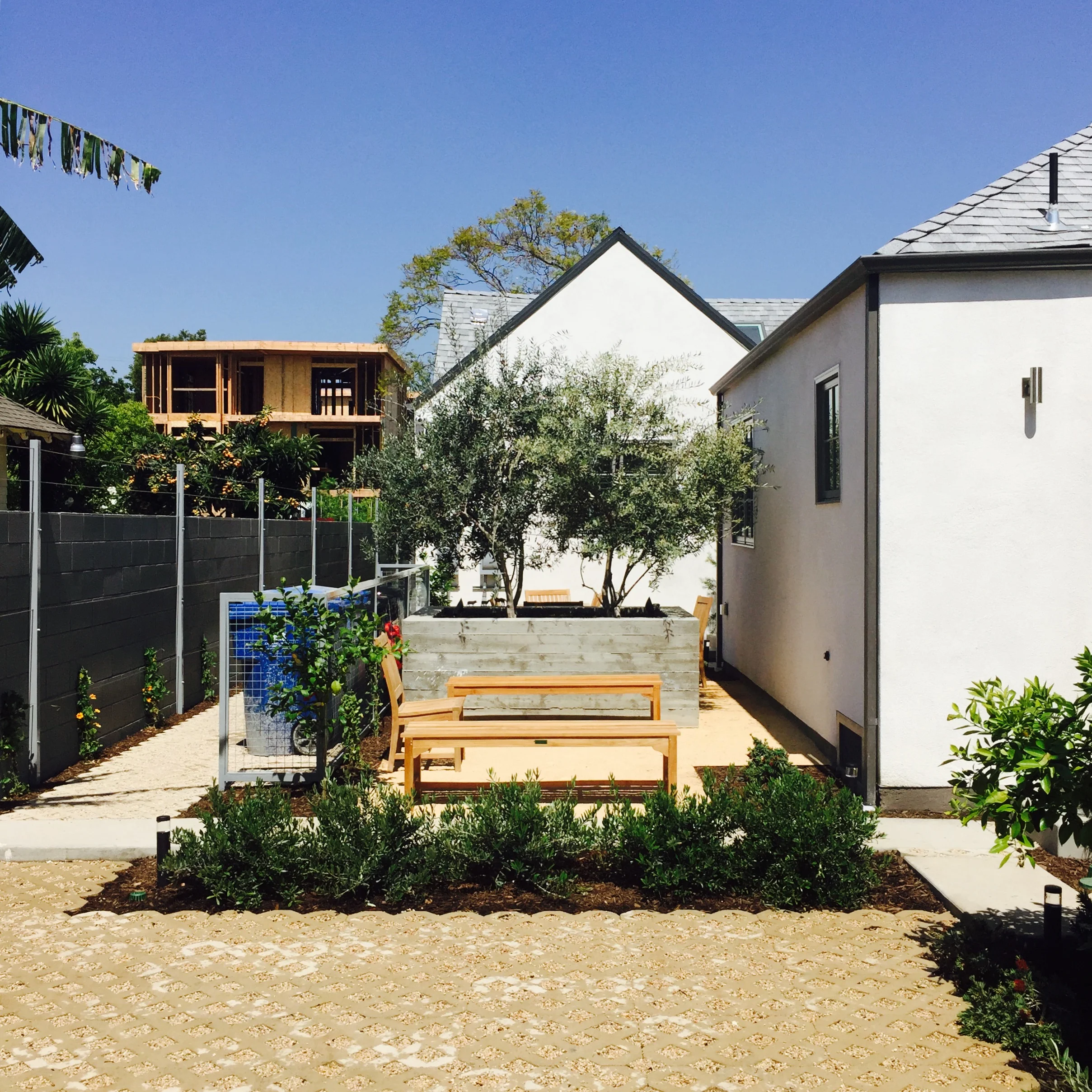

Vines planted along block wall at west property line.

APRIL 2016

APRIL 2016

APRIL 2016

Child labor.

APRIL 2016

APRIL 2016

APRIL 2016

Supplemental gates installed at facade line on El Centro.

APRIL 2016

APRIL 2016

APRIL 2016

Hollywood Firewood!

MAY 2016

MAY 2016

MAY 2016

Parkway landscaping complete.

MAY 2016

MAY 2016

MAY 2016

String lights and fire pit. Now that's living in LA.

MAY 2016

MAY 2016

MAY 2016

Party time.

JULY 2016

JULY 2016

JULY 2016

That was fun.
